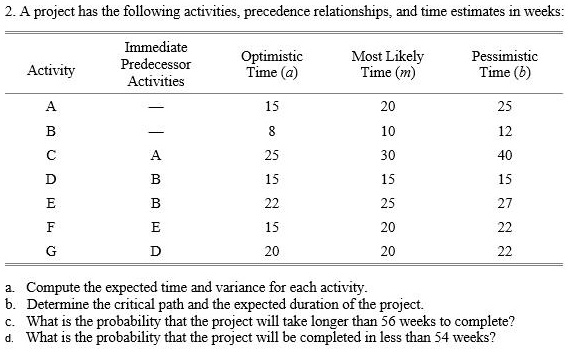

00:01
Hello students, according to the given question by observing we can say that expected time will be equal to optimistic time plus 4 into most likely time plus pessimistic time is divided by 6.
00:50
Now variance will be equal to pessimistic time minus optimistic time is divided by 6 whole square.
01:23
Now here there is an activity and here there is an expected time and here it is variance.
01:41
Now for the activity a expected time will be 15 plus 4 into 19 plus 25 is divided by 6 which is equal to 19 .33 and variance will be 25 minus 15 is divided by 6.
02:13
Which is equal to 2 .7778.
02:18
In the activity b, expected time will be 8 plus 4 into 11 plus 12 is divided by 6 which is equal to 10 .67.
02:35
And the variance will be 12 minus 8 is divided by 6.
02:42
4 square which is equal to 0 .4444.
02:49
Now for the activity c, expected time will be 25 plus 4 into 29 plus 40 is divided by 6 which is equal to 30 .17 and the variance will be 40 minus 40.
03:14
25 is divided by 6 whole square which is equal to 6 .25.
03:25
For the activity d, expected time will be 15 plus 4 into 15 plus 15 is divided by 6 which is equal to 15.
03:41
And the variance will be 15 minus 15 is divided by 6 whole square which is equal to 0 and for the activity e the expected time will be 22 plus 4 into 24 plus 27 is divided by 6 which is equal to 24 .1 is divided by 6 which is equal to 24 .1 and the variance is 27 minus 22 is divided by 6 whole square which is equal to 0 .6644...
