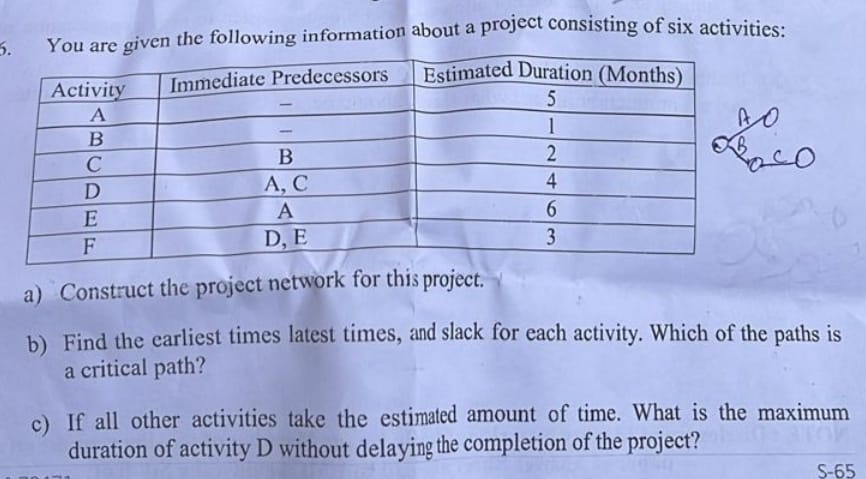

You are given the following information about a project consisting of six activities: \begin{tabular}{|c|c|c|} \hline Activity & Immediate Predecessors & Estimated Duration (Months) \\ \hline A & - & 5 \\ \hline B & - & 1 \\ \hline C & B & 2 \\ \hline D & A, C & 4 \\ \hline E & A & 6 \\ \hline F & D, E & 3 \\ \hline \end{tabular} a) Construct the project network for this project. b) Find the earliest times latest times, and slack for each activity. Which of the paths is a critical path? c) If all other activities take the estimated amount of time. What is the maximum duration of activity \( \mathrm{D} \) without delaying the completion of the project?
Added by Ashmeet
Close
Step 1
In this case, activities A and B have no predecessors. - Draw nodes for each activity and connect them based on their dependencies. - Activity A starts independently. - Activity B starts independently. - Activity C follows B. - Activity D follows A and Show more…
Show all steps
Your feedback will help us improve your experience
Sri K and 91 other Intro Stats / AP Statistics educators are ready to help you.
Ask a new question
Labs
Want to see this concept in action?
Explore this concept interactively to see how it behaves as you change inputs.
Key Concepts
Recommended Videos
The following represents a project with known activity times. All times are in weeks. Activity Immediate Predecessor Time A - 5 B - 3 C A 3 D B 6 E C,D 4 F B 5 G E,F 4 a) Using the data in the Table, what is the minimum possible time required for completing the project? b) Using the data in the Table, what is the latest possible time that C may be started without delaying completion of the project? c) Using the data in the Table, determine the latest time activity A can be finished and not delay any activity? d) Using the data in the Table, compute the latest finish time for activity E.
Sri K.
Question 4 (25 Marks) Draw the network corresponding to the following information. Also, complete the table, identify the critical path, and specify project completion time. Activity Immediate Predecessor(s) Time (Weeks) A --- 3 B --- 4 C A 6 D B 9 E B 6 F C, D 6 G D, E 8 H G, F 9 Activity Earliest Start Earliest Finish Latest Start Latest Finish Slack A B C D E F G H
Adi S.
Recommended Textbooks
Elementary Statistics a Step by Step Approach
The Practice of Statistics for AP
Introductory Statistics
18,000,000+
Students on Numerade
Trusted by students at 8,000+ universities
Watch the video solution with this free unlock.
EMAIL
PASSWORD
