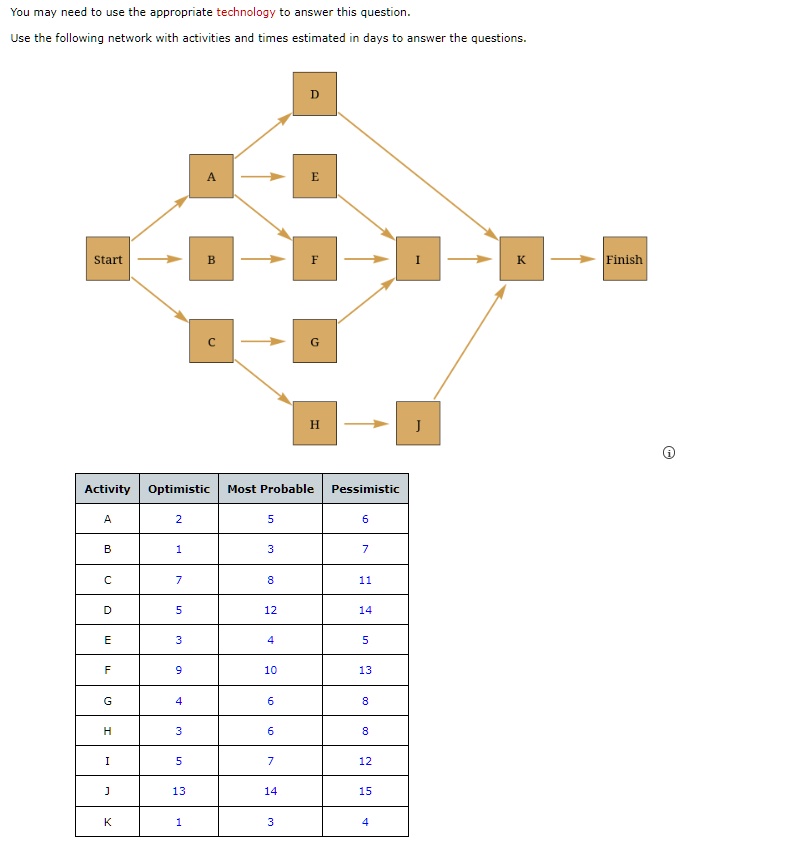

You may need to use the appropriate technology to answer this question. Use the following network with activities and times estimated in days to answer the questions. D A E Start B F I K Finish C G H J ? Activity Optimistic Most Probable Pessimistic A 2 5 6 B 1 3 7 C 7 8 11 D 5 12 14 E 3 4 5 F 9 10 13 G 4 6 8 H 3 6 8 I 5 7 12 J 13 14 15 K 1 3 4
Added by William M.
Close
Step 1
67 days - For Activity B: (1 + 4 * 7 + 11) / 6 = (1 + 28 + 11) / 6 = 40 / 6 = 6.67 days - For Activity C: (7 + 4 * 8 + 11) / 6 = (7 + 32 + 11) / 6 = 50 / 6 = 8.33 days - For Activity D: (5 + 4 * 12 + 14) / 6 = (5 + 48 + 14) / 6 = 67 / 6 = 11.17 days - For Activity Show more…
Show all steps
Your feedback will help us improve your experience
Sri K and 61 other Intro Stats / AP Statistics educators are ready to help you.
Ask a new question
Labs
Want to see this concept in action?
Explore this concept interactively to see how it behaves as you change inputs.
Key Concepts
Recommended Videos
Given the following network with activities and times estimated in days, Activity Optimistic Most Probable Pessimistic A 2 5 6 B 1 3 7 C 6 7 10 D 5 12 14 E 3 4 5 F 8 9 12 G 4 6 8 H 3 6 8 I 5 7 12 J 12 13 14 K 1 3 4 a. Find the mean activity times (t). b. What is the expected time to complete the project? What is the Critical Path
Sri K.
Days Activity Optimistic Most Probable Pessimistic Immediate Predecessors a 8 10 12 - b 6 7 9 - c 3 3 4 - d 10 20 30 a e 6 7 8 c f 9 10 11 b, d, e g 6 7 10 b, d, e h 14 15 16 f i 10 11 13 f j 6 7 8 g, h k 4 7 8 i, j l 1 2 4 g, h 1. Determine the expected time and variance for each activity. 2. Construct a network. 3. Determine the critical path. 4. Project completion time. 5. Draw the corresponding normal curve.
Problem 4: A project consists of seven activities with the time estimates as follows: a) Construct the PERT/CPM network for this problem. You should draw the network on paper, take a picture, and paste it into sheet 4. All calculation must be done on Excel for verification. (1 point) b) What is the expected project completion time? What is the critical path? (0.5 point) c) What is the probability that the project can be completed within 30 days? (0.5 point)
Recommended Textbooks
Elementary Statistics a Step by Step Approach
The Practice of Statistics for AP
Introductory Statistics
Transcript
Watch the video solution with this free unlock.
EMAIL
PASSWORD
