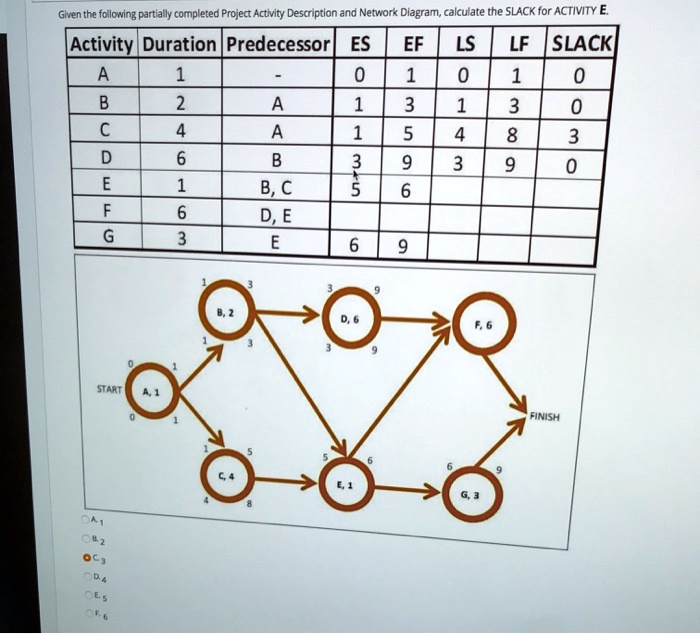

Given the following partially completed Project Activity Description and Network Diagram, calculate the SLACK for ACTIVITY E. Activity Duration Predecessor ES EF LS LF SLACK A 1 0 1 0 1 0 B 2 A 1 3 1 3 0 C 4 A 1 5 4 8 3 D 6 B 3 9 3 9 0 E 1 B, C 5 6 F 6 D, E G 3 E 6 9 0 1 START A, 1 0 1 1 3 3 9 B, 2 D, 6 F, 6 3 3 9 5 5 6 6 9 C, 4 E, 1 G, 3 8 FINISH OA1 OB2 OC3 OD4 OE5 OF6
Added by Michael C.
Close
Step 1
First, we need to identify the activities and their durations. From the given information, we have: Activity A: Duration = 3 Activity B: Duration = 4 Activity C: Duration = 1 Activity D: Duration = 5 Activity E: Duration = 8 Show more…
Show all steps
Your feedback will help us improve your experience
Maujee Lal and 53 other Algebra educators are ready to help you.
Ask a new question
Labs
Want to see this concept in action?
Explore this concept interactively to see how it behaves as you change inputs.
Key Concepts
Recommended Videos
Consider the following project network; with task duration data provided: START FINISH Which of the following is the completion time for this project? a. 11 days b. 10 days c. 14 days d. 12 days e. 13 days
Derrick D.
Sri K.
A network consists of the activities in the following list. Times are given in weeks. Activity Preceding Duration A -- 8 B -- 3 C A 7 D A, B 3 E C 6 F D 8 Required: a. Draw the network diagram. (5 marks) b. Calculate the ES, EF, LS, LF, and Slack for each activity. (12 marks) c. What is project completion time? (3 marks)
Maitreya E.
Recommended Textbooks
Elementary and Intermediate Algebra
Algebra and Trigonometry
18,000,000+
Students on Numerade
Trusted by students at 8,000+ universities
Watch the video solution with this free unlock.
EMAIL
PASSWORD
