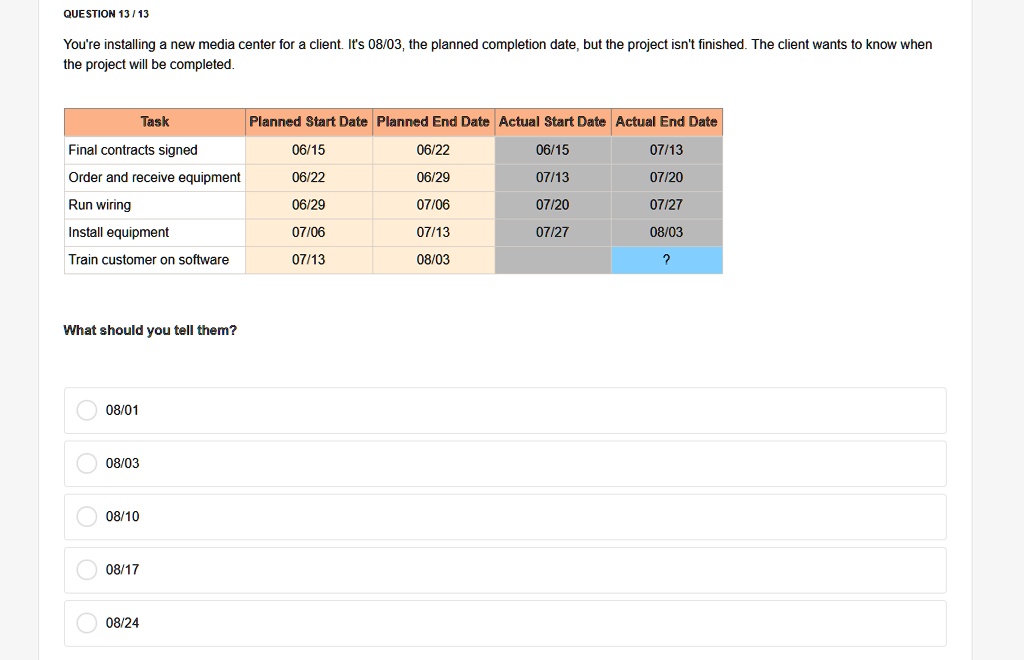

So here we want to determine when our project will be completed given that we're running behind.
00:08
We were supposed to start the contract signing and finish it on 6 -15 and finish 6 -22.
00:20
So we had seven days to complete that but instead we're starting as planned on the 15th but there are some holdups and we finish instead on 7 -13.
00:34
And then we cannot start ordering and receiving equipment until we're finished with that contract.
00:41
Then we start right away on the same day so 6 -22.
00:46
So if our contract wasn't signed until the 13th of july and we start ordering right away on the 13th and then it takes seven days to get all the equipment in.
01:00
So the planned ending date was 6 -29 and now the actual it still takes seven days.
01:07
We finish on the 20th.
01:08
Then we start running the wiring right away just as we had planned to start wiring the same day as we finished receiving the last piece of equipment.
01:20
So here too we finish receiving equipment on the 20th.
01:24
That means we start wiring on the 20th of july...
